EXECUTIVE BRIEF
Analyst Perspective
Siloed risks are risky business for any enterprise.
![]() Valence Howden Principal Research Director, CIO Practice |
![]() Brittany Lutes Senior Research Analyst, CIO Practice |
Risk is an inherent part of life but not very well understood or executed within organizations. This has led to risk being avoided or, when it’s implemented, being performed in isolated siloes with inconsistencies in understanding of impact and terminology.
Looking at risk in an integrated way within an organization drives a truer sense of the thresholds and levels of risks an organization is facing – making it easier to manage and leverage risk while reducing risks associated with different mitigation responses to the same risk events.
This opens the door to using risk information – not only to prevent negative impacts but as a strategic differentiator in decision making. It helps you know which risks are worth taking, driving strong positive outcomes for your organization.
Executive Summary
Your Challenge
IT has several challenges when it comes to addressing risk management:
- Risk is unavoidable. Without a formal program to manage IT risk, you may be unaware of your severest IT risks.
- The business could be making decisions that are not informed by risk.
- Reacting to risks after they occur can be costly and crippling, yet it is one of the most common tactics used by IT departments.
Common Obstacles
Many IT organizations realize these obstacles:
- IT risks and business risks are often addressed separately, causing inconsistencies in the approach.
- Security risk receives such a high profile that it often eclipses other important IT risks, leaving the organization vulnerable.
- Failing to include the business in IT risk management leaves IT leaders too accountable; the business must have accountability as well.
Info-Tech’s Approach
- Transform your ad hoc IT risk management processes into a formalized, ongoing program and increase risk management success.
- Take a proactive stance against IT threats and vulnerabilities by identifying and assessing IT’s greatest risks before they occur.
- Involve key stakeholders, including the business senior management team, to gain buy-in and to focus on the IT risks most critical to the organization.
Info-Tech Insight
IT risk is business risk. Every IT risk has business implications. Create an IT risk management program that shares accountability with the business.
Ad hoc approaches to managing risk fail because…
If you are like the majority of IT departments, you do not have a consistent and comprehensive strategy for managing IT risk.
- Ad hoc risk management is reactionary.
- Ad hoc risk management is often focused only on IT security.
- Ad hoc risk management lacks alignment with business objectives.
The results:
- Increased business risk exposure caused by a lack of understanding of the impact of IT risks on the business.
- Increased IT non-compliance, resulting in costly settlements and fines.
- IT audit failure.
- Ineffective management of risk caused by poor risk information and wrong risk response decisions.
- Increased unnecessary and avoidable IT failures and fixes.
58% of organizations still lack a systematic and robust method to actually report on risks (Source: AICPA, 2021)
Data is an invaluable asset – ensure it’s protected
Case Studies
|
|
|
Risk management is a business enabler
Formalize risk management to increase your likelihood of success.
By identifying areas of risk exposure and creating solutions proactively, obstacles can be removed or circumvented before they become a real problem.
A certain amount of risk is healthy and can stimulate innovation:
- A formal risk management strategy doesn’t mean trying to mitigate every possible risk; it means exposing the organization to the right amount of risk.
- Taking a formal risk management approach allows an organization to thoughtfully choose which risks it is willing to accept.
- Organizations with high risk management maturity will vault themselves ahead of the competition because they will be aware of which risks to prepare for, which risks to ignore, and which risks to take.
Only 12% of organizations are using risk as a strategic tool most or all of the time (Source: AICPA, 2021)
IT risk is enterprise risk
Accountability for IT risks and the decisions made to address them should be shared between IT and the business.
![]() |
IT risks have a direct and often aggregated impact on enterprise risks and opportunities in the same way other business risks can. This relationship must be understood and addressed through integrated risk management to ensure a consistent approach to risk. |
Follow the steps of this blueprint to build or optimize your IT risk management program
![]() Start Here |
PHASE 1
Review IT Risk Fundamentals and Governance |
PHASE 2
Identify and Assess IT Risk |
PHASE 3
Monitor, Report, and Respond to IT Risk |
|||
1.1Review IT Risk Management Fundamentals |
1.2Establish a Risk Governance Framework |
2.1Identify IT Risks |
2.2Assess and Prioritize IT Risks |
3.1Monitor IT Risks and Develop Risk Responses |
3.2Report IT Risk Priorities |

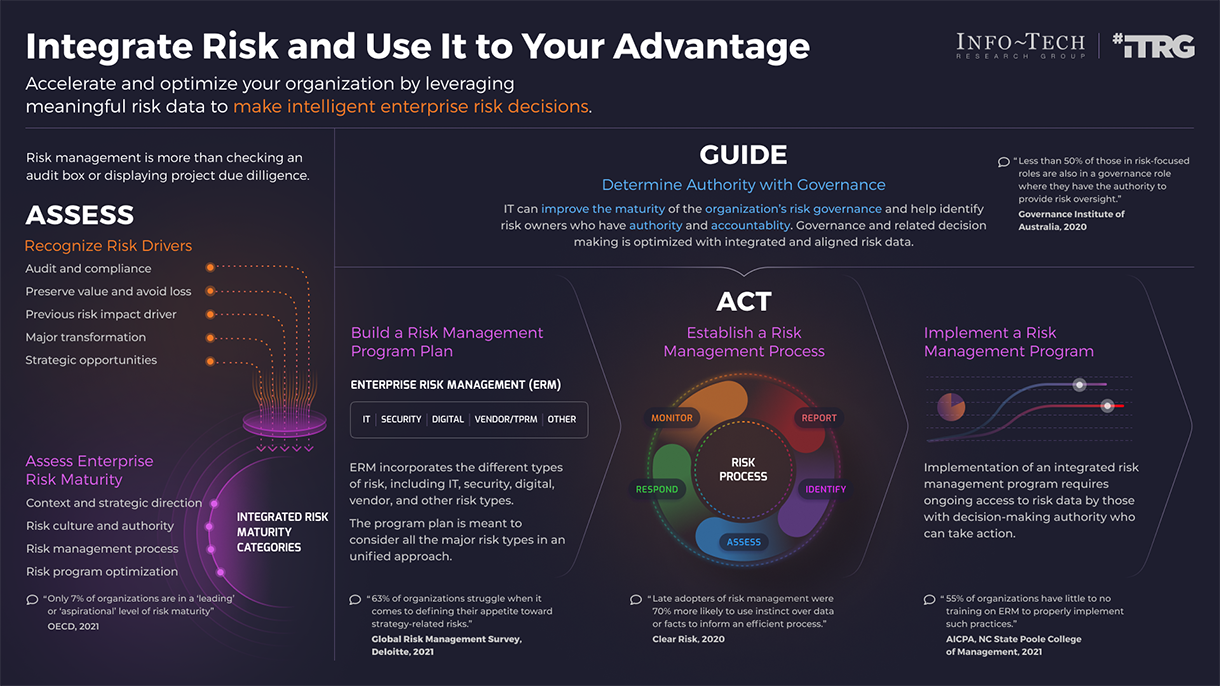

Integrate Risk and Use It to Your Advantage
Accelerate and optimize your organization by leveraging meaningful risk data to make intelligent enterprise risk decisions.
Risk management is more than checking an audit box or demonstrating project due diligence.
Risk Drivers
|
![]() |
Only 7% of organizations are in a “leading” or “aspirational” level of risk maturity. (OECD, 2021) | 63% of organizations struggle when it comes to defining their appetite toward strategy related risks. (“Global Risk Management Survey,” Deloitte, 2021) | Late adopters of risk management were 70% more likely to use instinct over data or facts to inform an efficient process. (Clear Risk, 2020) | 55% of organizations have little to no training on ERM to properly implement such practices. (AICPA, NC State Poole College of Management, 2021) |
1. Assess Enterprise Risk Maturity | 3. Build a Risk Management Program Plan | 4. Establish Risk Management Processes | 5. Implement a Risk Management Program | ||
2. Determine Authority with Governance
Unfortunately, less than 50% of those in risk focused roles are also in a governance role where they have the authority to provide risk oversight. (Governance Institute of Australia, 2020) |
|||||
IT can improve the maturity of the organization’s risk governance and help identify risk owners who have authority and accountability.
Governance and related decision making is optimized with integrated and aligned risk data. |
![]() |

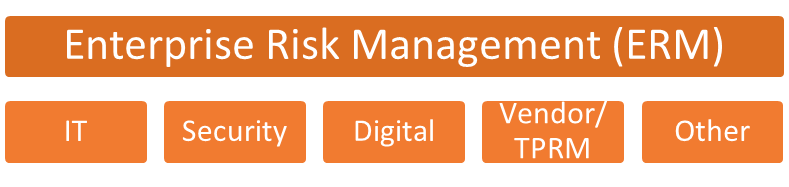

![]() ERM incorporates the different types of risk, including IT, security, digital, vendor, and other risk types. The program plan is meant to consider all the major risk types in a unified approach. |
![]() |
Implementation of an integrated risk management program requires ongoing access to risk data by those with decision making authority who can take action. |
Blueprint deliverables
Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals:
Key deliverable:Risk Management Program ManualUse the tools and activities in each phase of the blueprint to create a comprehensive, customized program manual for the ongoing management of IT risk. ![]() |
Integrated Risk Maturity Assessment
Assess the organization's current maturity and readiness for integrated risk management (IRM). |
![]() |
Centralized Risk Register
The repository for all the risks that have been identified within your environment. |
![]() |
Risk Costing Tool
A potential cost-benefit analysis of possible risk responses to determine a good method to move forward. |
![]() |
Risk Report & Risk Event Action Plan
A method to report risk severity and hold risk owners accountable for chosen method of responding. |
![]() |
Benefit from industry-leading best practices
As a part of our research process, we used the COSO, ISO 31000, and COBIT 2019 frameworks. Contextualizing IT risk management within these frameworks ensured that our project-focused approach is grounded in industry-leading best practices for managing IT risk.
|
Risk Management can help organizations increase the likelihood of achieving objectives, improve the identification of opportunities and threats, and effectively allocate and use resources for risk treatment. (ISO 31000) |
|
Abandon ad hoc risk management
A strong risk management foundation is valuable when building your IT risk management program.This research covers the following IT risk fundamentals:
|
Drivers of Formalized Risk Management: |
|
Drivers External to IT | ||
External Audit | Internal Audit | |
Mandated by ERM | ||
Occurrence of Risk Event | ||
Demonstrating IT’s value to the business | Proactive initiative | |
Emerging IT risk awareness | ||
Grassroots Drivers |
Blueprint benefits
IT Benefits
|
Business Benefits
|
Info-Tech offers various levels of support to best suit your needs
DIY Toolkit |
Guided Implementation |
Workshop |
Consulting |
"Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful." | "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track." | "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place." | "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project." |
Diagnostics and consistent frameworks used throughout all four options
Guided Implementation
A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.
A typical GI is 6 to 8 calls over the course of 3 to 6 months.
What does a typical GI on this topic look like?
- Call #1: Assess current risk maturity and organizational buy-in.
- Call #2: Establish an IT risk council and determine IT risk management program goals.
- Call #3: Identify the risk categories used to organize risk events.
- Call #4: Identify the threshold for risk the organization can withstand.
- Call #5: Create a method to assess risk event severity.
- Call #6: Establish a method to monitor priority risks and consider possible risk responses.
- Call #7: Communicate risk priorities to the business and implement risk management plan.
Phase 1
Phase 2
Phase 3
Workshop Overview
Contact your account representative for more information.
workshops@infotech.com1-888-670-8889
Day 1 | Day 2 | Day 3 | Day 4 | Day 5 | |
Activities |
Review IT Risk Fundamentals and Governance1.1 Assess current program maturity 1.2 Complete RACI chart 1.3 Create the IT risk council 1.4 Identify and engage key stakeholders 1.5 Add organization-specific risk scenarios 1.6 Identify risk events |
Identify IT Risks2.1 Identify risk events (continued) 2.2 Augment risk event list using COBIT5 processes 2.3 Determine the threshold for (un)acceptable risk 2.4 Create impact and probability scales 2.5 Select a technique to measure reputational cost 2.6 Conduct risk severity level assessment |
Assess IT Risks3.1 Conduct risk severity level assessment 3.2 Document the proximity of the risk event 3.3 Conduct expected cost assessment 3.4 Develop key risk indicators (KRIs) and escalation protocols 3.5 Perform root cause analysis 3.6 Identify and assess risk responses |
Monitor, Report, and Respond to IT Risk4.1 Identify and assess risk responses 4.2 Risk response cost-benefit analysis 4.3 Create multi-year cost projections 4.4 Review techniques for embedding risk management in IT 4.5 Finalize the Risk Report and Risk Management Program Manual 4.6 Transfer ownership of risk responses to project managers |
Next Steps and Wrap-Up (offsite)5.1 Complete in-progress deliverables from previous four days 5.2 Set up review time for workshop deliverables and to discuss next steps |
Outcomes |
|
|
|
|
|
Build an IT Risk Management Program
Phase 1
Review IT Risk Fundamentals and Governance
Phase 1
|
Phase 2
|
Phase 3
|
This phase will walk you through the following activities:
- Gain buy-in from senior leadership
- Assess current program maturity
- Identify obstacles and pain points
- Determine the risk culture of the organization
- Develop risk management goals
- Develop SMART project metrics
- Create the IT risk council
- Complete a RACI chart
This phase involves the following participants:
- IT executive leadership
- Business executive leadership
Step 1.1
Review IT Risk Management Fundamentals
Activities
- 1.1.1 Gain buy-in from senior leadership
- 1.1.2 Assess current program maturity
This step involves the following participants:
- IT executive leadership
- Business executive leadership
Outcomes of this step
- Reviewed key IT principles and terminology
- Gained understanding of the relationship between IT risk management and ERM
- Introduced to Info-Tech’s IT Risk Management Framework
- Obtained the support of senior leadership
Step 1.1 | Step 1.2 |
Effective IT risk management is possible with or without ERM
Whether or not your organization has ERM, integrating your IT risk management program with the business is possible.
Most IT departments find themselves in one of these two organizational frameworks for managing IT risk:
Core Responsibilities | With an ERM | Without an ERM |
|
Senior Leadership Team | Senior Leadership Team |
|
ERM | IT Risk Management |
|
IT Risk Management | |
Pro: IT’s risk management responsibilities are defined (assessment schedules, escalation and reporting procedures).
Con: IT may lack autonomy to implement IT risk management best practices. |
Pro: IT is free to create its own IT risk council and develop customized processes that serve its unique needs.
Con: Lack of clear reporting procedures and mechanisms to share accountability with the business. |
Info-Tech’s IT risk management framework walks you through each step to achieve risk readiness
IT Risk Management Framework
Risk Governance
|
![]() |
Risk Identification
|
Risk Response
|
Risk Assessment
|
